Skip to content
Project Financials

Everything a subcontractor needs to see the money on a job, and nothing else.

No scheduling module, no client portal, no selections. Project Financials does the finance half of a construction suite, deeply, so the people who already know the numbers can put them in.

All plans

Projects and draws, with retention done right

A project is a contract, a start and end date, a PM and a retention rate. Each pay-app draw records what you billed, what was held, when it was submitted and when it got paid. The app computes net due, days outstanding and the retention balance, and flags draws past your overdue threshold.

  • Awarded, pipeline (with probability) and closed statuses
  • Draw-by-draw retention held and released
  • Overdue badges based on your payment terms
  • Remaining to bill and retention held on every project header
Draw 7, Sep 2026, submitted Sep 25
Gross billed this period$244,053
Retention held (10%)($24,405)
Net due$219,648
Paid Oct 28, 33 days$219,648
Retention held to date$196,851
Retention percentage comes from the project; released on substantial completion or a date you set.
All plans

Change orders that move the contract only when approved

Log a change order the day you price it. Pending COs stay visible on the project and in the company totals so nobody forgets them, but only approved COs adjust the contract value that the WIP schedule and the forecast run on.

  • Additions and deductions, with running net change
  • Company-wide CO totals on the dashboard
  • History kept for the audit log on Business
Change orderStatusAmount
CO-03 Added panel feeders, bldg BApproved$58,050
CO-04 Delete site lighting altApproved($47,736)
CO-05 Owner-requested reworkPending$21,400
Adjusted contract$2,160,314
Approved change orders move the adjusted contract; pending ones are shown but not counted.
All plans

Costs by month and category, pasted straight from Excel

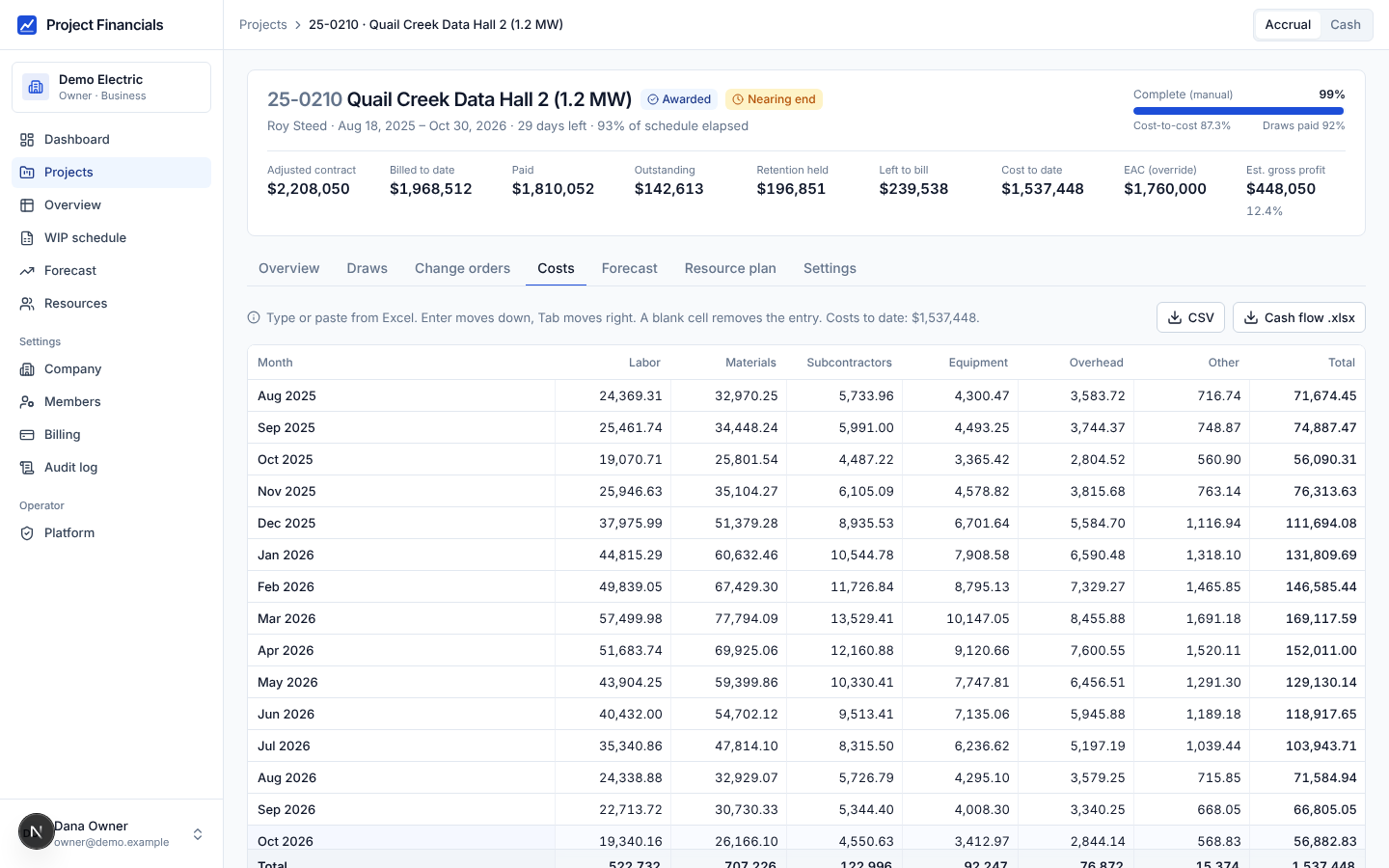

A grid of months by category: labor, materials, subcontractors, equipment, overhead and other, or the categories you define. Type into it or paste a block from your accounting export. Totals, cost to date and cost-to-cost percent complete update as you go.

  • Paste from Excel, tab and enter move like a spreadsheet
  • Your own category list per company
  • Bulk cost import on Professional and above
Project costs grid: months down the side, labor, materials, subcontractors, equipment, overhead and other across, with totals
All plans

Cash-flow curves, accrual or cash basis

Every project and the whole company get a monthly inflow, outflow, net and cumulative view. On accrual basis a draw counts when it is submitted; on cash basis it counts when it is paid and retention sits out until it is released. Flip between them with one toggle in the top bar.

  • Actual months plus forecast months, hatched so you can tell them apart
  • Reserve line from your company settings
  • Cumulative net and the month it bottoms out
$0K$200K$400K$600KReserve $350KNowJulAugSepOctNovDecJanFebMarAprMayJun$585K net, 12 months
Draws by submitted or paid date, retention held until release, costs by month. Solid is actual; dashed is PM forecast.
Professional and above

PM forecasting: cost-to-complete by the person who knows

The project manager owns the forecast for their jobs. Past months fill in from actual draws and costs. For the months ahead the PM types the inflow and outflow they expect; any month they leave alone is spread evenly to the end date. Each number carries its source so the office can see what was typed, what was measured, and what was assumed.

  • Per-project EAC override and percent complete
  • Forecast margin vs original estimate, with profit-fade flags
  • Trend overlay from the last three actual months
MonthInflowOutflowSource
Oct 2026$244,053$186,900actual
Nov 2026$260,000$201,000manual
Dec 2026$265,000$195,000manual
Jan 2027$272,180$188,300auto
Feb 2027$188,400$140,200auto
Actuals come from draws and costs. The PM types over the months they know. The rest is spread evenly to the end date.
Simplified on Starter, full on Professional and above

A full WIP schedule for your bonding agent

Pick an as-of date and the schedule is rebuilt from the draws and costs on file: contract, approved COs, adjusted contract, estimated cost at completion, estimated gross profit, cost to date, percent complete, earned revenue, billed to date, under-billings, over-billings and backlog. Full or simplified, awarded or closed, totals row included.

  • Snapshots frozen at month-end for close and for your surety
  • Excel and PDF with the as-of date printed on them
  • 24 months of history and multi-period comparison on Business
WIP schedule screen: totals for adjusted contracts, earned revenue, under-billings, over-billings, gross profit and backlog, with one row per project
Basic on Starter, full on Professional and above

Company dashboard and gauges

Five gauges answer the Sunday-night questions: net cash against reserve, this month's billing against capacity, draws paid, forecast margin against target, and outstanding receivables against capacity. Under them, fifteen months of inflow and outflow with net and cumulative lines, and an in-flight table of every awarded project.

  • Include pipeline, weighted by probability, with one switch
  • Thresholds you set on Business
  • PDF pack for the monthly owner meeting
Net cash vs reserve
$687K of $350K
Billing vs capacity
$244K of $650K
Draws paid
$2.91M of $3.44M
Forecast margin
target 20%
Outstanding vs capacity
$489K of $650K
Business

Resource planning: people, trucks, lifts and tool kits by week

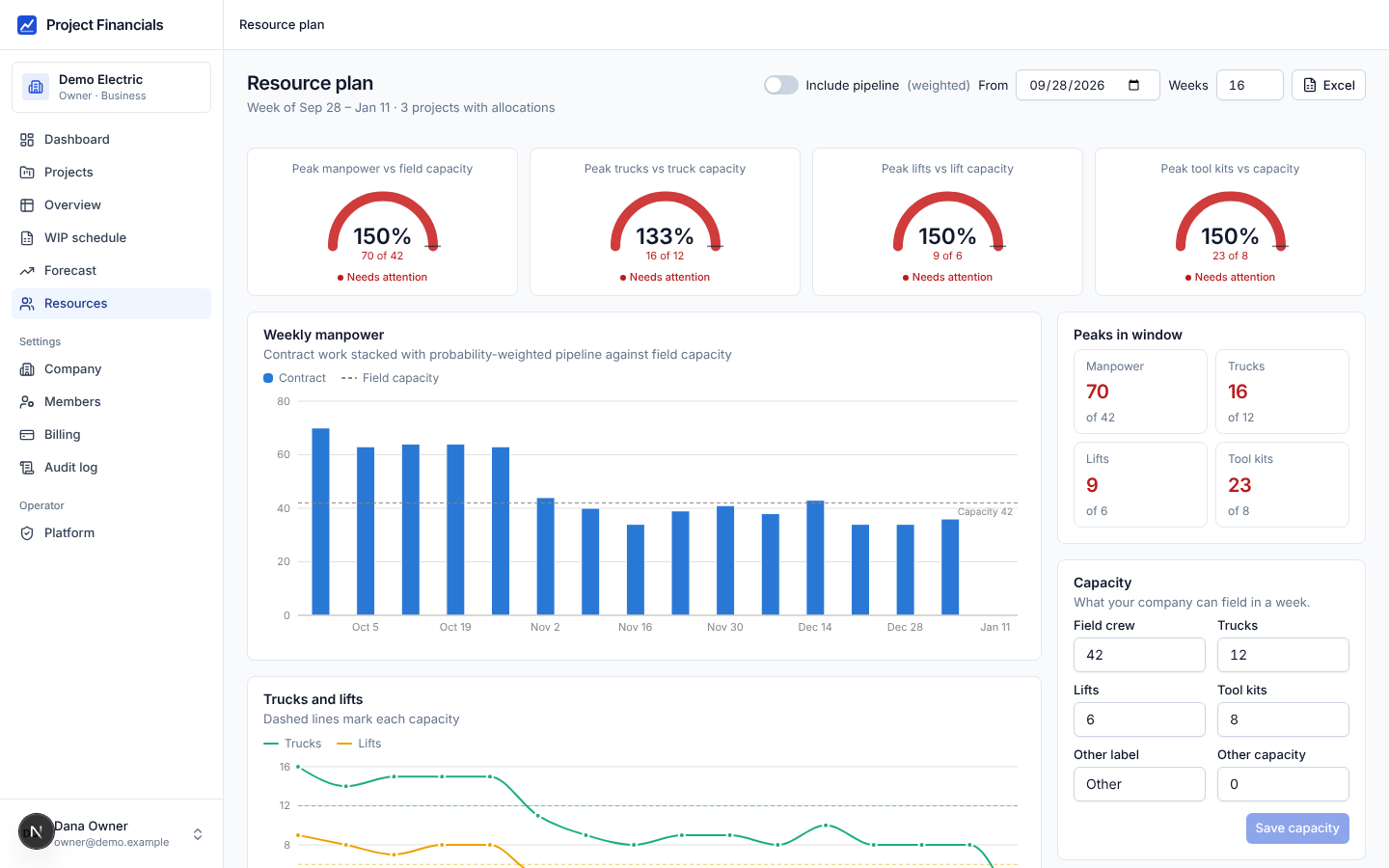

Each project gets a weekly grid of what it needs. The company sets what it can field. The planner stacks awarded work, adds pipeline weighted by probability, and shows the weeks you are over in red, for manpower and for each equipment type separately.

  • Peaks in the window against each capacity
  • Per-project grids editable by the PM
  • Excel export of the whole plan
Resource plan screen: peak gauges for manpower, trucks, lifts and tool kits; weekly manpower bars against a capacity line; trucks and lifts lines
Admin and viewer on Starter, all roles on Professional and above

Roles and per-project access

Owners handle billing. Admins manage members. PMs run projects and see the whole company. Field users and viewers see only the projects you assign, so a foreman can enter costs on their job without seeing another PM's margin.

  • Invitations by email, roles changed any time
  • A PM's own projects filter
  • Audit log of every change on Business
 OwnerAdminPMFieldViewer
Billing✓————
Members and access✓✓———
Projects and settings✓✓✓——
Draws, COs, costs, forecast✓✓✓assignedread
WIP and dashboard✓✓✓own rowsown rows
Exports✓✓✓ownown
Field and viewer roles see only the projects you assign them.
Excel on Starter, everything on Professional and above

Excel and PDF out, Excel in

Every table has an export button. The WIP schedule, cash flow and resource plan come out as real spreadsheets with numeric cells, not pictures of tables. Projects and cost grids come in from Excel. And the whole company exports as a zip, any time, on any plan.

WIP schedulexlsx, pdfSurety-format columns, totals row, as-of date
Project cash flowxlsxMonth by month inflow, outflow, net, cumulative
Dashboard packpdfKPIs, gauges, 15-month chart, in-flight table
Resource planxlsxWeekly manpower, trucks, lifts per project
EverythingzipEvery table as csv, on request from Settings
Importsxlsx, pasteProjects list, monthly costs grid

Which plan has which feature is laid out on the pricing page. The trial runs on Professional, so you can see forecasting and the full WIP schedule with your own numbers.

Produce your first WIP schedule this week.

Fourteen days, full Professional features, no credit card. Import your projects from Excel, enter the draws and costs you already have, and hand your bonding agent a schedule you can stand behind.
